Wednesday, September 30, 2015

Sept 30 - Progress Report

2nd Floor Slab Roof  Beam and Support - almost ready for Slab cement Pouring


Stairs hardened and Ready




Room 1 at 1st Floor - Palitada complete



Working on Front Terrace Canopy


Doorjamb (Amba) Ready for Installation


2nd Floor: Front Terrace Overview - Golden Grains





Thursday, September 24, 2015

House Frontage - we will copy the EXTERIOR design of this Modern House

Click the house model below to ENLARGE.



As of Sept 25 Work in Progress Below:















Monday, September 21, 2015

Sept 22- Expenses Report

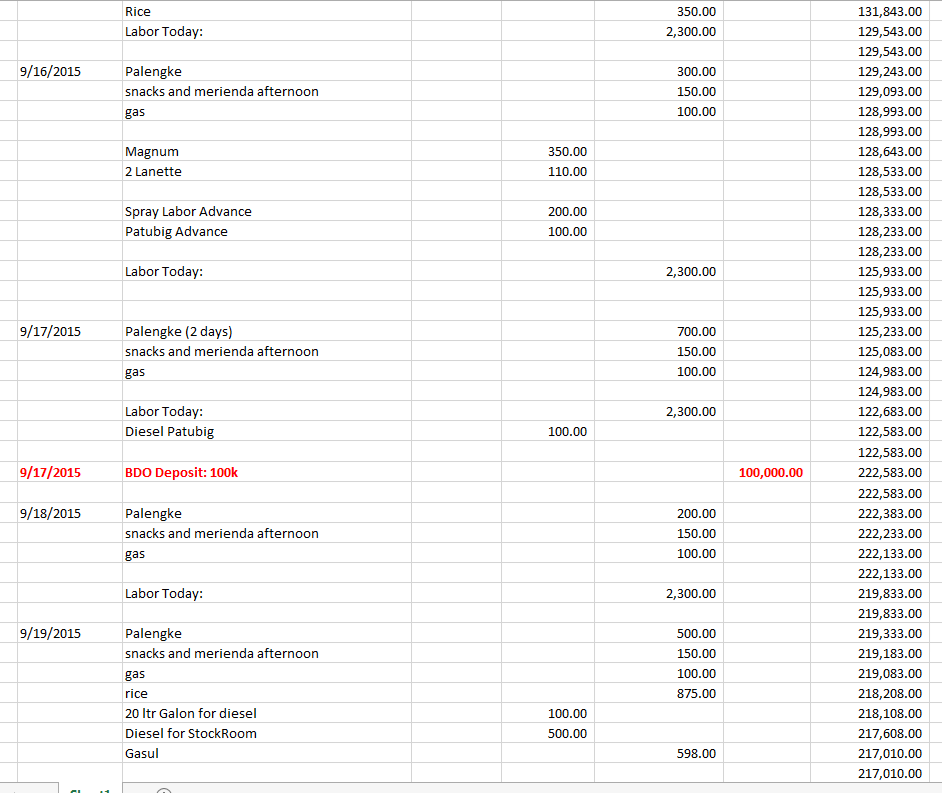

Below is our Expenses Report covering September 8 - September 22 2015. Cash Available is P145,498.00 While expenses  is P 140,006.00 for house project covering September 8 - September 22 2015


click any IMAGE below to Enlarge








Sept 22 - 2nd floor - Work on Progress
